Mid-and-Long-Term Roadmap towards the Decommissioning of TEPCO's Fukushima Daiichi Nuclear Power Station Units 1-4

What’s New

Contaminated Water Issue

Countermeasures to Manage Contaminated Water: Measures and Progress
Measures Progress
Remove contamination source Decontamination of contaminated water using multi-nuclide removal equipment, etc. (equipment for removing radionuclides from contaminated water) In operation The decontamination process is completed by the end of May 2015, except for the water contaminated during the initial period of the accident itself.
The water which has undergone strontium removal will then also be treated by the multi-nuclide removal equipment as the second decontamination process. (The process is estimated to be finished following the completion of decontamination of the contaminated water stored in the tanks.)
Removal of highly contaminated water in the underground tunnels (trenches) on the sea side of the building Ongoing Almost all of the highly contaminated water in the trenches was removed by 30th July 2015.

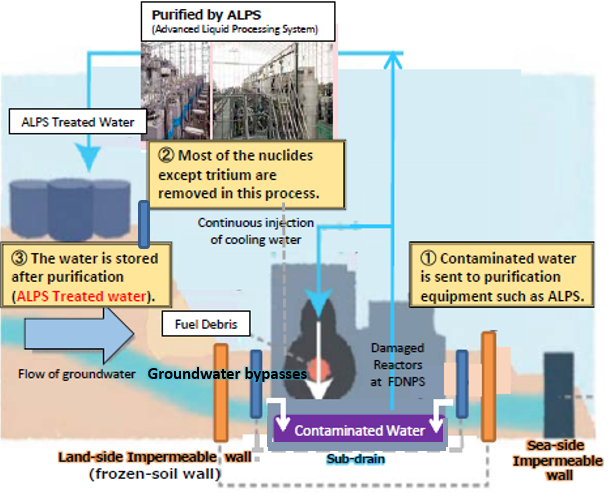

Isolate water from contamination Pumping from the well on the land-side of the building into the sea (groundwater bypassing system) In operation Drainage started in late May 2014. The amount of water being contaminated has decreased to approx. 80 m3/day.
Pumping of ground water from wells around buildings (sub-drains) and draining of the water to the sea after decontamination Ongoing Explanation to stakeholders is ongoing. Drainage of the water to the sea will not start without their consent.
Installation of land-side impermeable frozen walls Ongoing The installation work of the frozen duct at land-side sites is completed. A pilot land-side freezing operation, where the freezing operation requires more time, has been underway since 30th April, 2015.
Waterproof pavement to prevent groundwater inflow Ongoing Paving of more than 80% of the planned site has been completed.
Prevent leakage of contaminated water Heightening and doubling of tank fences Completed /
In operation
Completed in the middle of July 2014.
Their efficacy was proved when a typhoon struck in the autumn of 2014.
Ground improvement by sodium silicate (water glass) Completed /
In operation
Completed in March 2014.
Installation of sea-side impermeable walls Ongoing More than 90% of the construction is completed.
Increase the number of tanks In operation (under further maintenance) 800,000 tons of tank capacity was secured during FY 2014, two years earlier than the time projected in the previous Mid- and Long-Term Roadmap.
